Cautionary Note:
Please respect fences and adjacent landowners by not attempting to enter the site. Environmental assessments confirm land impacted by hazardous substances and petroleum hydrocarbons, multiple areas of drums with unknown substances, and abandoned buildings with asbestos and lead-based paint. Anyone accessing the site (legally and illegal trespassers) has the potential to track contaminants to surrounding areas and/or injure themselves amid the debris.

PROJECT TIMELINE

A project of this complexity will take several years to complete.  To realize the project vision, the site must be reclaimed to safe levels in order to be suitable for the intended reuse.  Final completion of the project is expected to be achieved within a five to ten year timeframe, depending on the level of contamination and reclamation needed.  The period from early 2015 through December 2017 included project feasibility discussions, initial environmental assessments, securing site ownership, outreach, and formation of the Acme Working Group.  Beginning in 2018, activities will be more focused on addressing the most pressing and manageable environmental and safety hazards at the site, including removal and proper disposal of the drums and asbestos containing materials and PCBs in storage areas.  These activities will stabilize the site and prevent further contamination.  Future assessments, anticipated to begin in the fall of 2018, will determine the extent of contamination and lead to the development of a mitigation plan and cost estimates.  More detailed community discussions on the future uses of the site will follow the assessment work.

October 2017-

USEPA completes Phase II Environmental Assessment

August 2017-

Community Visioning Session

January 2019

Community Update

September 2015-

Exploratory Committee

contracts Feasibility Study

January 2017-

USEPA completes Phase I Environmental Assessment

June 2016-

SCCD applies to USEPA Targeted Brownfield Assessment Program

Summer 2019-Summer 2021

Additional assessments and mitigation planning through EPA Assessment Grant

December 2017-

Formation of

Acme Working Group

May 2015-

Exploratory Committee

(SCCD, SCLT, and TNC)

Initial Meeting

October 2015-June 2017

SCLT works on property ownership issues

June 2017-

SCCD assumes site ownership

January 2018-

Site enrolled in WDEQ Voluntary Remediation Program (VRP)

Mitigation

Activities

TBD

Fall 2018

Initiate removal of drums, some asbestos, and debris

PROJECT FUNDING

As of April 30, 2019, over $564,000 have been invested in the project from a combination of state and federal programs, foundation grants, private donations, local government sources, and other partner contributions.  Over 80% of the project funding has come from state and federal programs and has been for initial site assessments and site reclamation (including stabilization) activities.   As the project progresses, expenses associated with reclamation, outreach, and reuse planning will continue to increase.  Check back here for periodic updates.  While much of the funding for assessments and mitigation is expected to come from federal and state programs, there are associated expenses that are not eligible for those programs.  Support from private foundations, local communities, and individuals will continue to be important.

Project Expenses

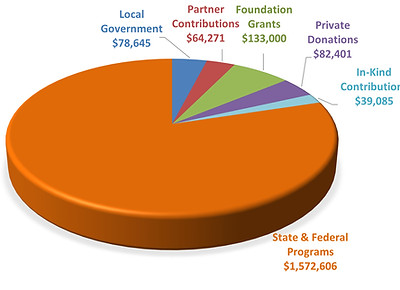

Project Income*

*Funding Programs/Grants:

US Environmental Protection Agency, State of Wyoming, Laura Jane Musser Foundation,

Wolf Creek Charitable Foundation, Wyoming Community Foundation

SITE CONDITION

Photo from Weston Solutions

Photo from Sheridan County Conservation District

Photo from Sheridan County Conservation District

Initial environmental assessments confirm land impacted by hazardous substances and petroleum hydrocarbons, multiple areas of drums with unknown substances, abandoned buildings contaminated with asbestos and lead-based paint, and debris.

Asbestos:  Significant amounts of friable and non-friable asbestos, some of it damaged, were identified within the buildings and in storage areas.  Trace amounts of asbestos were found in soils outside of the building. Over 60 cubic yards of bulk and loose asbestos were removed from the site in 2018; however there is still a large quantity within the building to be addressed.

Lead-based paint:  Large amounts of lead-based paint  were found on walls, ceilings, doors, and window components.  Poor condition and deterioration has led to flaking paint scattered throughout the buildings and outside surfaces.

Unknown drum contents:  Multiple areas of unlabeled drums are present across the site.  Many of the drums are in poor condition.  Assessed drums contain oxidizers, flammables, combustibles and non-combustibles.  Drums unable to be assessed present unknown hazards. Over 50 55 gallon drums and contents were removed in 2018.

Other contaminants:  Various metals, PCBs, petroleum hydrocarbons, and other known carcinogens were identified in soils, bank sediments, coal-ash piles, and groundwater.  While much of this contamination was present is low concentrations and mainly in shallow and surface soils, exposure risks via skin contact, inhalation, and ingestion are present for anyone accessing the site.
